SATURDAY, JULY 15, 2006


It was a little tough getting motivated to go to work this morning, but the job wasn't going to get done if I didn't do it, so at 7:30 I found myself, once again, op top of the staging with sander in hand.  The good news was that all I had to sand was the third section of the great room, on the front side only since the back side was part of the shed dormer that I would sand a little later from the second floor.  My immediate goal, these past several days, was to complete what I deemed to be the worse part of the job--the tallest portions of the great room, sanding and finishing.

While there was still a huge amount of area remaining to be sanded--the ceilings in the second floor, including the two dormers; the entire ceiling on the first floor beneath the floor joists; and, of course, all the log walls.  Such is the necessary dementia of large, overwhelming jobs that, by this point, I was almost looking forward to these "easy" tasks ahead.

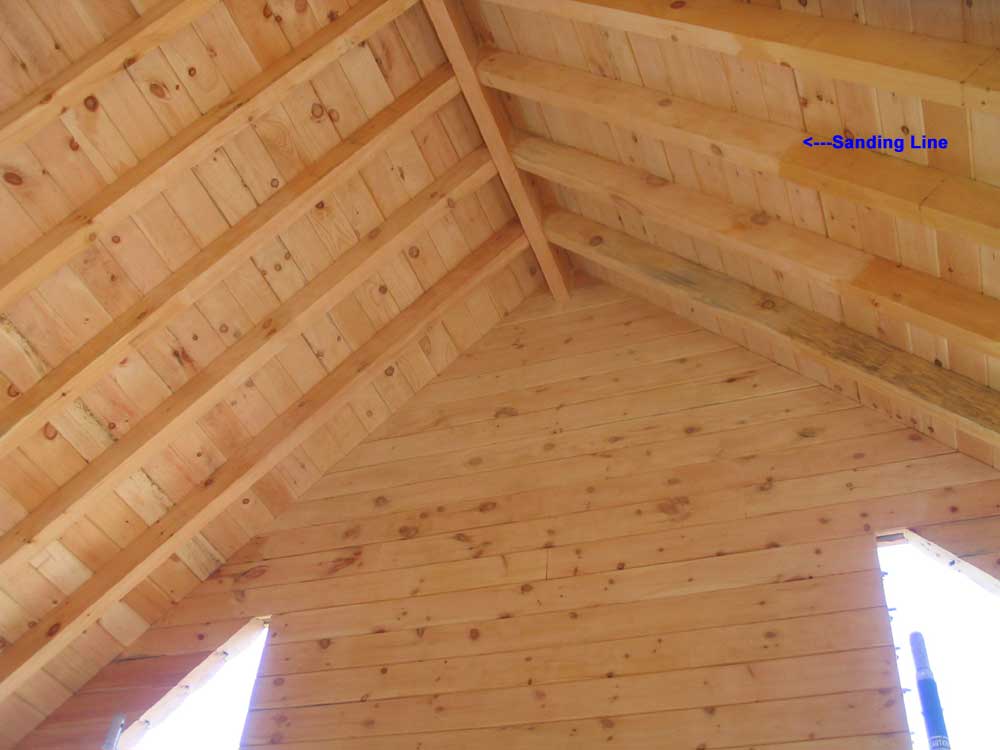

I finished up the sanding of this final area in a couple hours, and thankfully retired my sanding and breathing equipment for the (short-lived) time being.  There was one section remaining in the great room--the area directly above the stair case, where unfortunately the pipe staging would not fit.  I had another plan to stage this area, but that would wait for just a little while.  Meantime, I wanted to finish up with the remainder of the great room so that I'd never have to climb to the ridge again.

Now, I turned to the interior finishing.  We chose a clear, waterborne satin interior polyurethane for the job, as this choice would keep the fresh pine in its most natural state--lighter and less orangey than an oil-based finish, and without the fear of discoloration around wall hangings, etc.  The pine would darken slightly with age no matter what, but we wanted to keep it as bright and clean as possible.  Plus, waterborne finishes are easy to apply since they dry so fast, and can be rapidly overcoated--perfect for the ceiling job ahead.

As I had sanded, I had used an air hose and blow gun to clean away the sanding dust from each section, and at ceiling height this was good enough to prepare for the finish.   On the walls and lower ceilings, I planned to sand to a finer grit and clean a bit better where it would be more noticeable.  After some thought, I decided to brush-apply the finish.  The spray equipment I had would be awkward to use in this situation because the material cup was so small; I felt I would be always climbing down to refill.  And the extra hoses and such would just be a bother on the staging.  I could have rented a dedicated sprayer designed to pull directly from a 5-gallon bucket, but this was too much trouble, and I figured that the time I might "save" with spray equipment would be put to better use getting going right now, with a time-honored method with which I was very familiar and ready to go.  Brush it was.  I used a 4" brush designed for use with waterborne stains and polyurethanes.

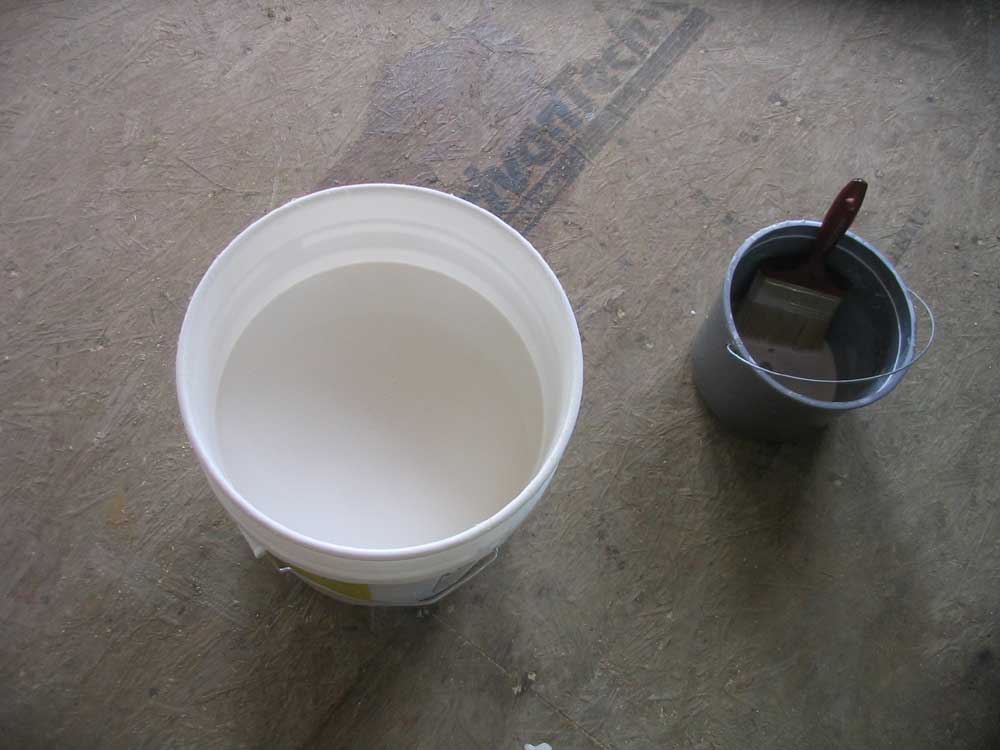

The finish wasn't that satisfying to apply; it is very watery and milky in appearance when it goes on, and the first coat soaked in to the wood with very little noticeable effect.  But the second coat was nicer and easier to apply, and began to leave behind a noticeable sheen.


Beginning in the section I had just finished sanding, since the staging was still there, I applied two coats of polyurethane--a first coat at the ridge and downward, wait an hour or so, and then a second coat directly on top of the first.  Then I removed the third lift of staging and repeated the process at that level.  I wasn't worried about lap marks for a couple reasons:  first, this sort of approach was unavoidable working at this height with this equipment; second, the grooves in the v-matched ceiling boards provided natural stopping points; and finally, the laps, if they were noticeable at all up close, would be invisible from the floor beneath.

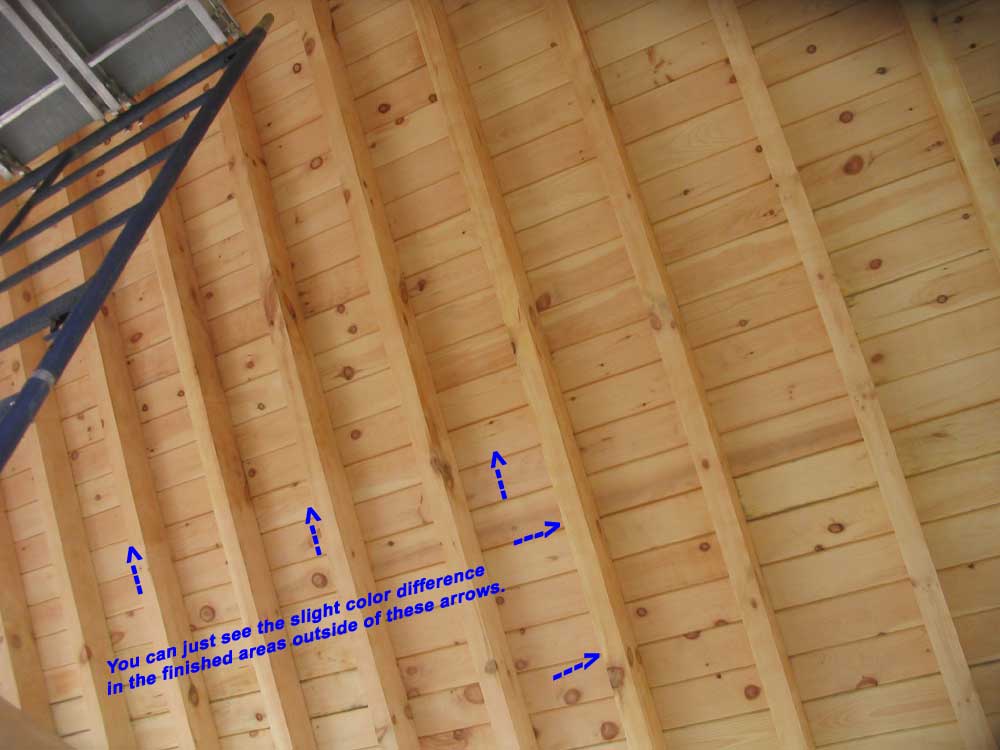

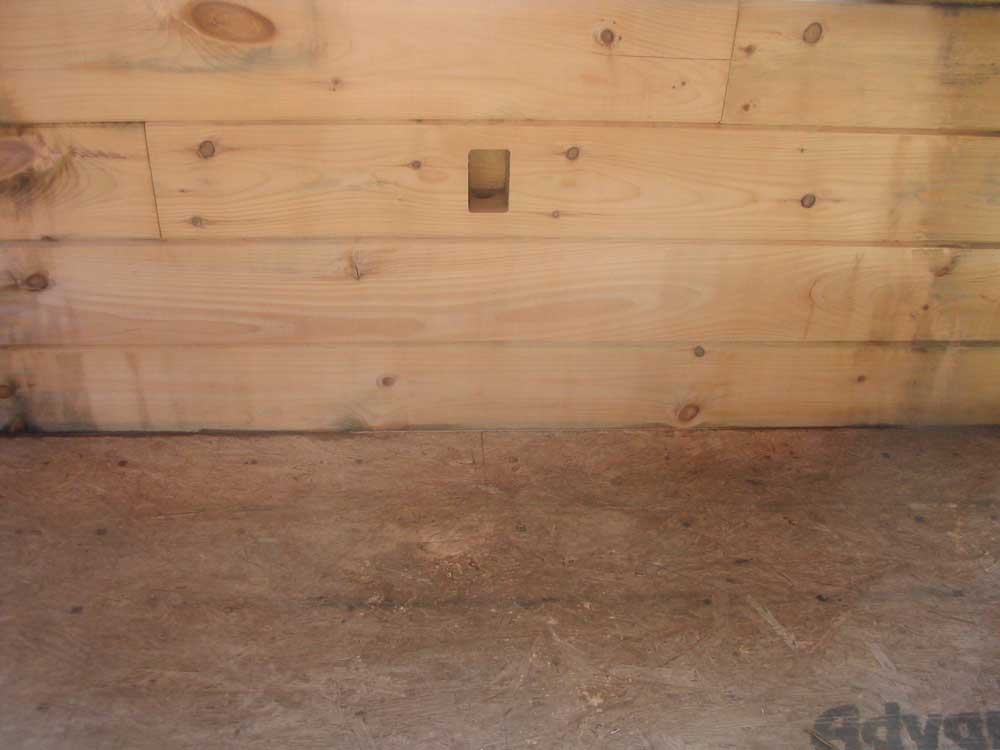

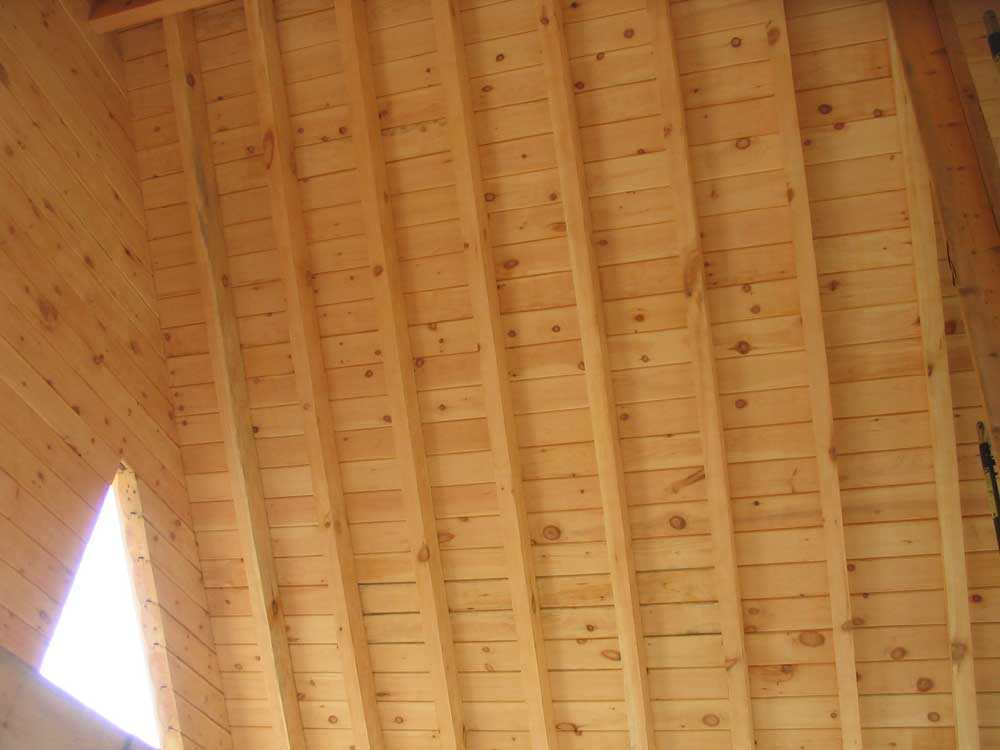

The finish just slightly darkened the freshly-sanded pine--a very subtle effect that maybe you can see in this photo.  2 coats of the poly was sufficient for the ceilings and served only to protect the wood and provide a very soft lustre.  I expected to use 3 coats on the walls, sanding lightly between coats in order to achieve a slightly richer end result.

Once I had finished the first section, I moved the staging over one bay and, starting at the ridge, began to repeat the process.  I managed to get 2 coats on one side of the ceiling at the top level before the day was over.  It looked like one more work day would see me to completion on this portion of the task, but that would have to wait till Monday:  I needed a day of rest, and a day to take care of a few other things on Sunday!

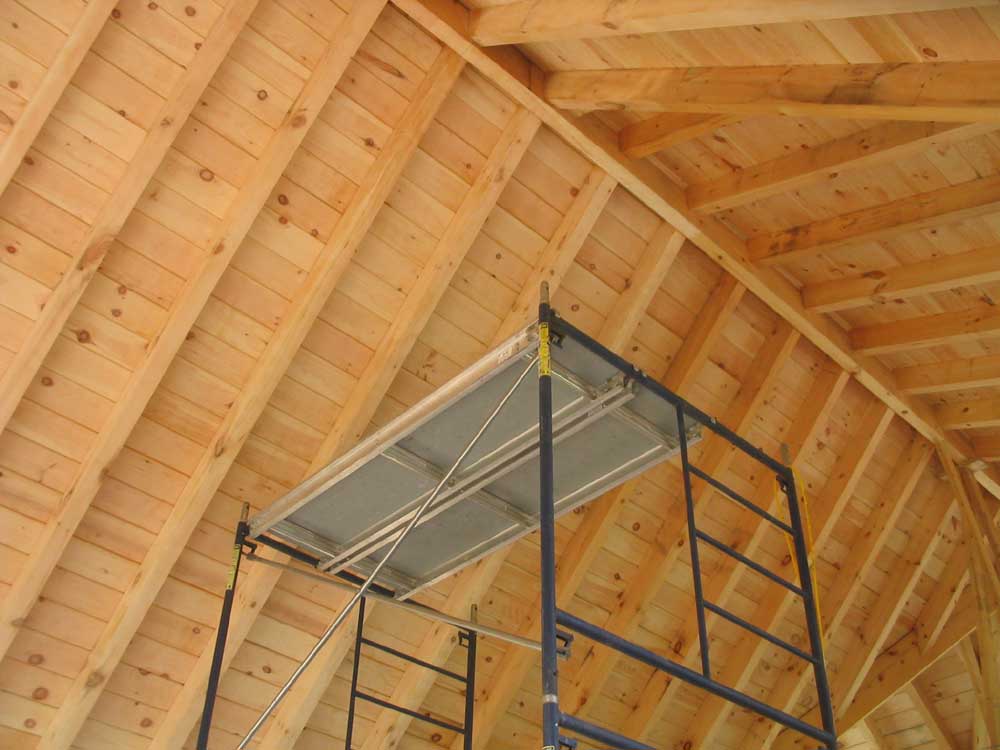

This process is difficult to photo document, so please forgive me the lack of photos.  In the end, you'll just have to come visit to see the true effect!


FRIDAY, JULY 14, 2006

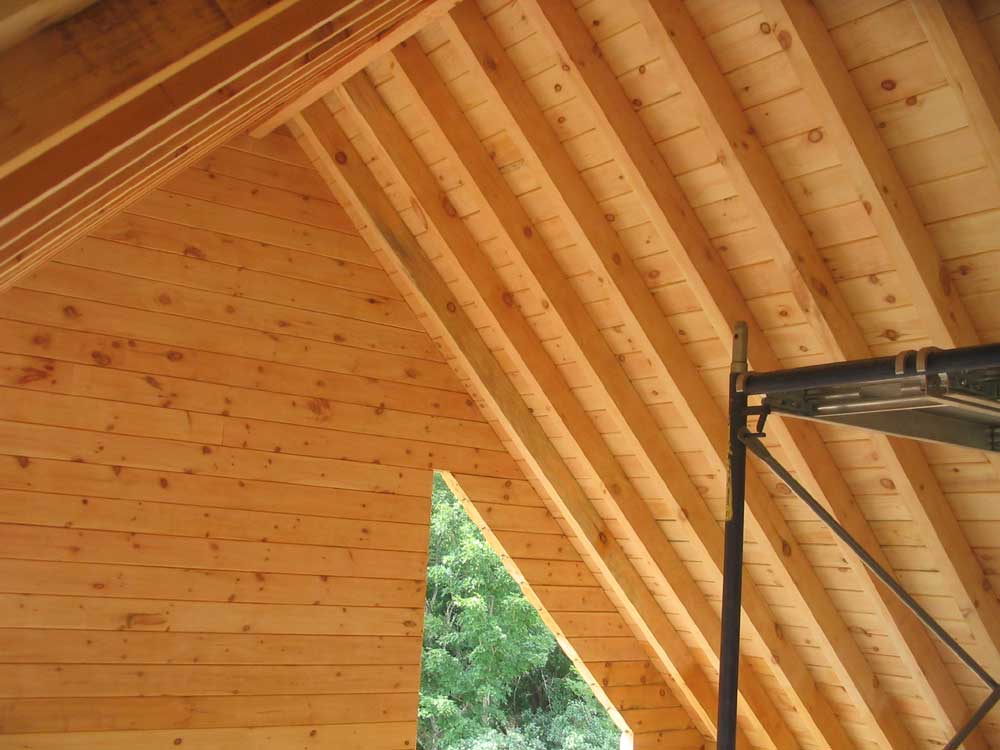

Today was all about sanding.  I started where I left off yesterday and sanded for about 10 hours today, making my way through a large portion of the great room ceiling.  The work was slowed significantly by the awkwardness of the pipe staging.  Because of the steeply-pitched roof, I could only reach relatively small areas at a time, after which I'd have to get down and readjust the staging to reach another area.

Up and down, down and up.  I don't know how many times I repositioned the staging--for height (three 5-foot lifts to reach the ridge and top portions of the ceiling, then down to two lifts to reach out closer to the eaves), for side-to-side position inside of the tight areas defined by the ceiling cross ties, and then from one "bay" (area between ties) to the next.  Because of the ties, I could not drag the assembled staging around, so to move from one section to another I had to disassemble down to a single lift and then build back up again.  This was time consuming, but was the only way.

I had earlier considered renting (or even buying, when I saw one in Uncle Henry's for a reasonable price) a scissor lift for this job, thinking that it would be extremely handy.  But this dream ended abruptly when I discovered that these weighed, alarmingly, about 2800lb. or more--far too heavy for the floor system.  Rats.

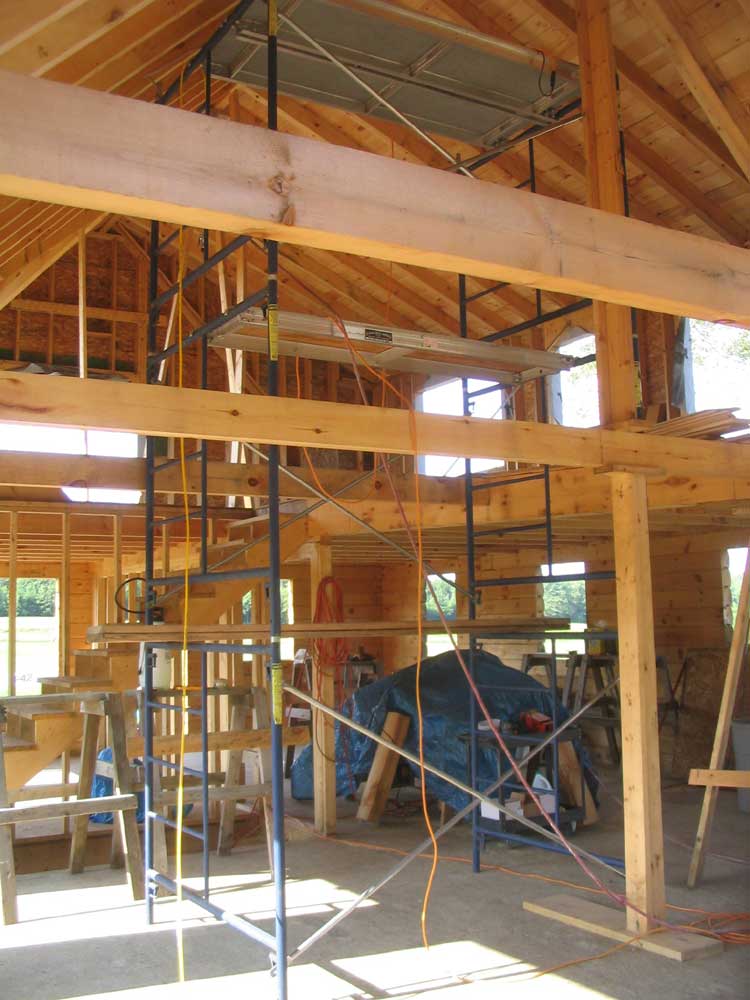

Pipe staging is pretty good for what it is, but on the third lift--15 feet to the top--every movement was by necessity in slow motion, to ensure that I didn't walk off a plank by accident, and because each movement tended to cause the staging to jitter badly.  With a lack of peripheral vision caused by the full face mask I was wearing, it paid to move slowly and take care.


By the end of an exhausting day, I had finished up the entire first bay, including the log gable wall, down to a height about 6 board widths from the top of the walls beneath, which area I could easily reach from a single layer of staging on the floor later, and had also completed the entire second bay--8 rafter sections on each side.  It was late and I was tired, but I moved the staging and set it up to the third level in the third bay, next to the staircase, so that it would be all ready to go in the morning.  I cleaned up the discarded sanding discs and laid everything out for the morning.

THURSDAY, JULY 13, 2006

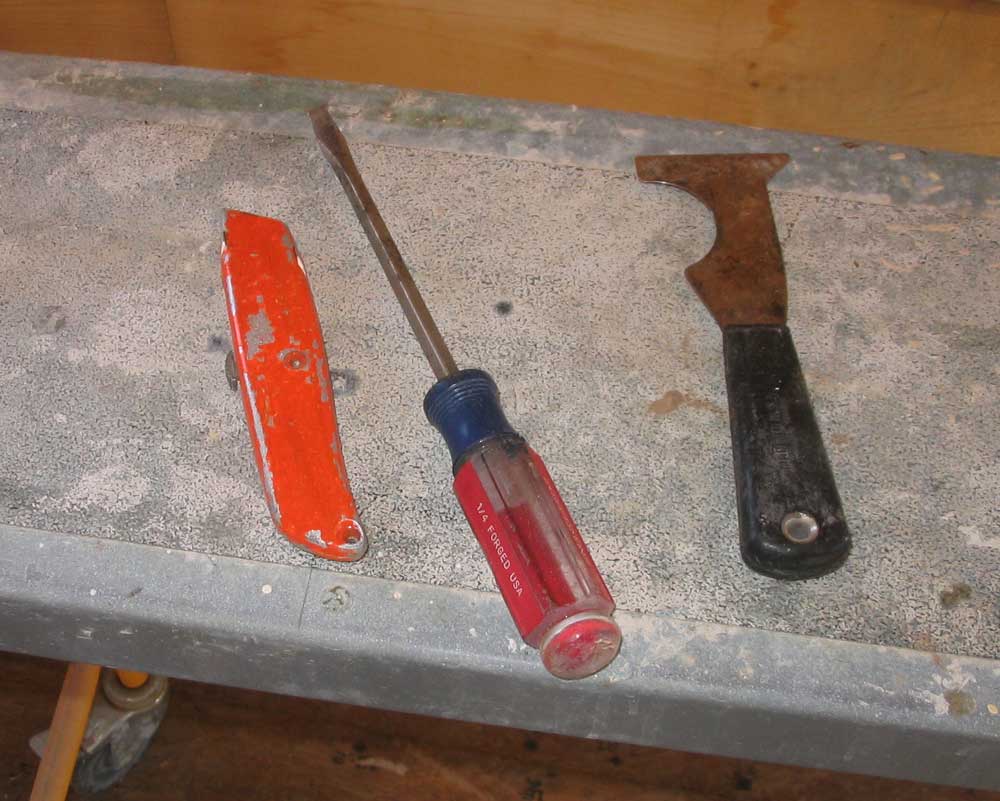

I thought my next move was going to be washing all the wood on the inside of the house with a recommended solution of water and a mixture of bleach and TSP.  During the course of construction, the wood had become somewhat weathered and stained in some areas, thanks to the weeks of endless rain that not only kept the interior exposed for a longer time, but also exacerbated the weathering and staining.  There was little I could do until the house was dried in.  With no water at the house yet, my first step was a very early morning trip to the store for 500' of hose, as well as a few other needed supplies.  By 0730, I was back and starting to get set up.

I wasn't looking forward to the task, but at least I thought it would be satisfying.  I tried a test patch on one of the worst weathered parts of the wall--beneath one of the windows, applying the water/bleach/TSP solution with a garden sprayer.  The wood lightened considerably, so it seemed that this would be worth the effort.

I wanted to begin on the ceilings and work downwards--for the obvious gravitational reasons as well as the sheer fact that I wanted to get the worst part over with.  The three lifts of pipe staging were still in place at the far end of the great room, so I began there.  I dragged hose, sprayer, goggles, and other needed things up to the top of the staging and prepared to go to work.   Almost immediately, I hated it.  There was no escaping the dripping water and bleach, and it turned the staging into a slippery jungle gym of death-defying proportions.  But the final straw was twofold:  first, the cleaning solution made almost no visible difference in the ceiling boards and rafters, which were not particularly weathered compared to the log walls; and the garden sprayer stopped working properly and would not dispense a fan of the material.

I rinsed off the mess and gingerly climbed down to regroup.  I could see no difference in the wood I had "cleaned" from the floor, and I quickly reconsidered the whole process.  Why did I need to wash the wood in this way?  I knew I would have to sand everything inside anyway...why get it all wet and nasty when sanding would accomplish the same thing and save a very unpleasant step in the process?  The bleach and such would probably work well on the outside of the logs later, though, since I didn't plan to sand those.

I wasn't geared up for sanding--that required a whole different group of equipment that I figured I would need for a few days--so it took me some time to retrieve sanders, sandpaper, respirator, compressor, hoses, and other paraphernalia from the shop and bring it to the house.  Eventually, I got everything I needed, and tried to get organized.  I tried sanding one of the worst-weathered logs in the great room with good results, so I went with this plan.

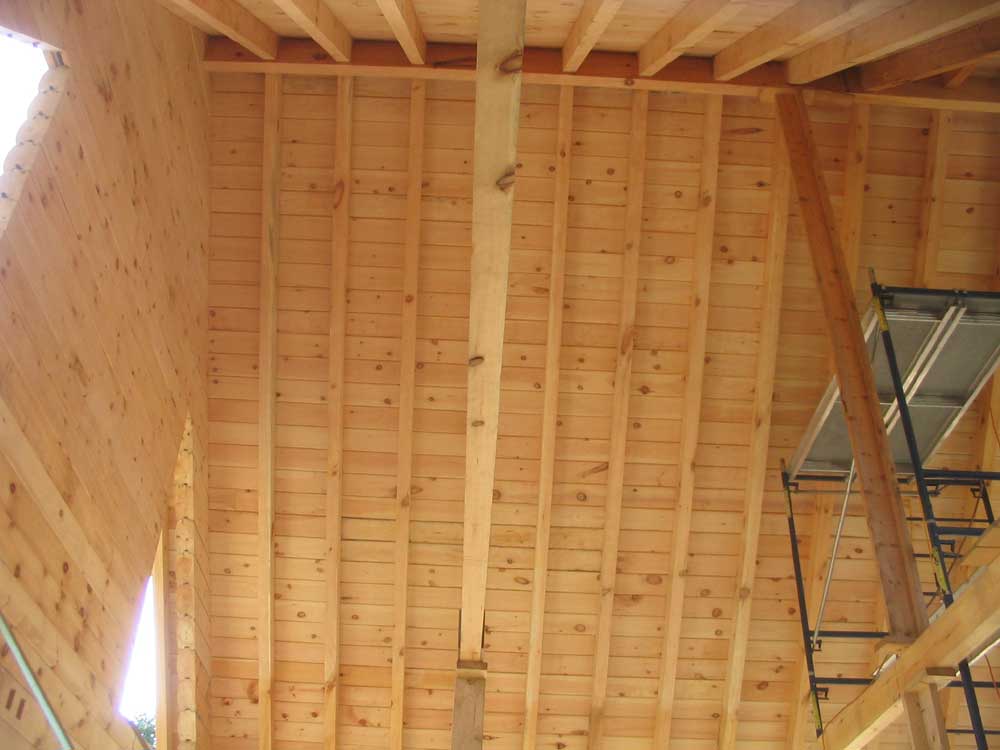

Because of the various ceiling ties in the great room, any major moves of the pipe staging involve completely dismantling the top two lifts so that the remaining lift can be dragged beneath the ties, which are only 8' off the floor.  So for obvious reasons, I wanted to minimize the number of times that I went through this process.  I had gotten the ceiling all wet where the staging was set up, so I had little choice but to wait until the wood dried and begin sanding there, rather than move elsewhere.  To fill the time, I worked on removing the squeezed-out caulking from between the logs in the great room.  I had done some of this here and there over the past few weeks, but now I spent a couple hours working on it, using a variety of tools including a 5-in-1 tool, a utility knife, and what turned out to be my favorite device:  and old flathead screwdriver with a slightly bent tip, which worked very well.  The caulking came off fairly easily, but since it was located in the v-groove between the logs, access was the challenging part.


After lunch, it seemed the wood was dry enough to sand, so I geared up for that.  It took several trips to bring all the tools and stuff up to the platform--sander, sandpaper, respirator mask and hose, ear protection, extension cord.  Some of the wood wasn't really dry enough, as it turned out, but it was OK to work with anyway..  So for the rest of the afternoon, I sanded.  It was slow going, as every step at that height required care and checking my position on the platform and to ensure that I wasn't hopelessly wrapped up in hoses and cords.  I sanded down as far as I could on the rafters, ceiling boards, and, in this case, the log gable wall.  I could reach two rafter spaces from my location on each side of center; when I was finished with those, I climbed down, dragged the staging as far as I could against the ceiling tie, and sanded another two.  Then, I lowered the planks to the top of the second lift of staging and repeated the process.

It was a long afternoon without a huge amount of progress, but I felt that I had the system figured out and that things would go much better and more quickly tomorrow.  I reached a logical stopping point at around 5, since I'd have to remove some wall braces in order to drag the staging closer to the eaves, so I cleaned up and then spent part of the evening removing the external staging that I had built through the window openings for the roofing process.  I was thrilled to see it go, but there sure were a lot of nails holding everything together!  This final photo shows the house sans staging for the first time in some weeks.

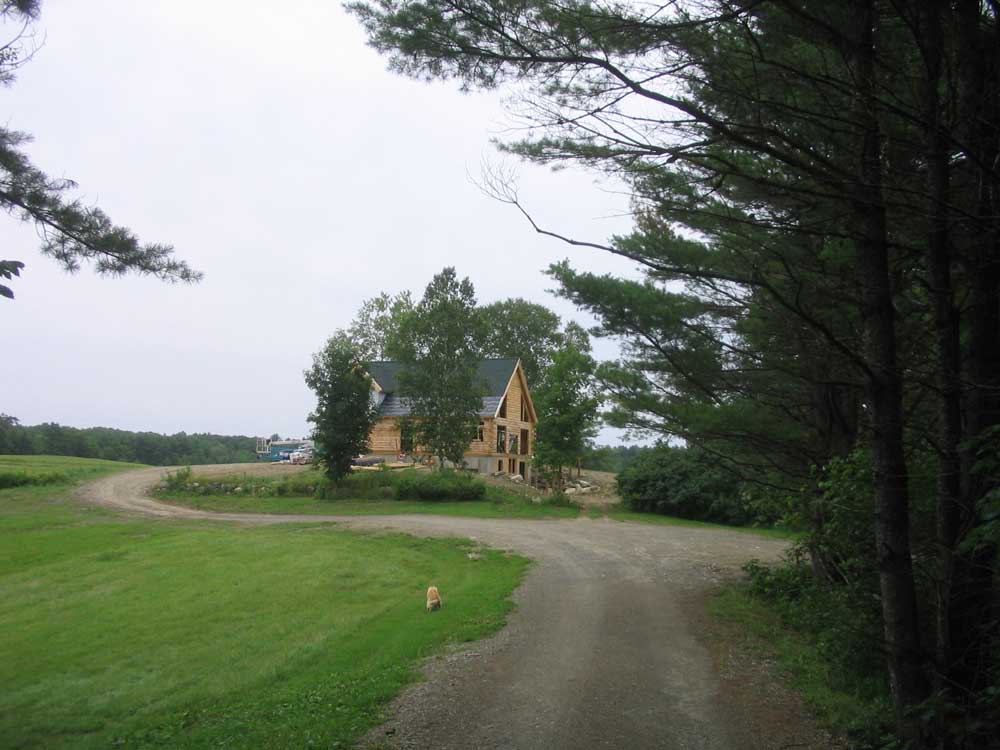

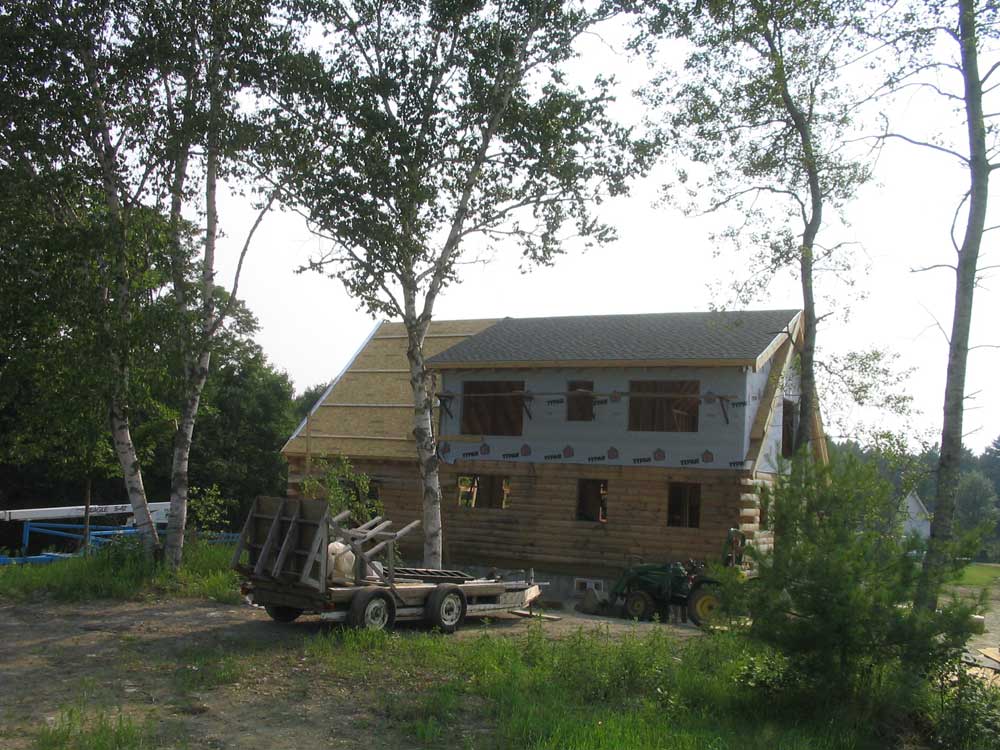

With bright sun this afternoon, I also took some better photos of the finished roof.




WEDNESDAY, JULY 12, 2006

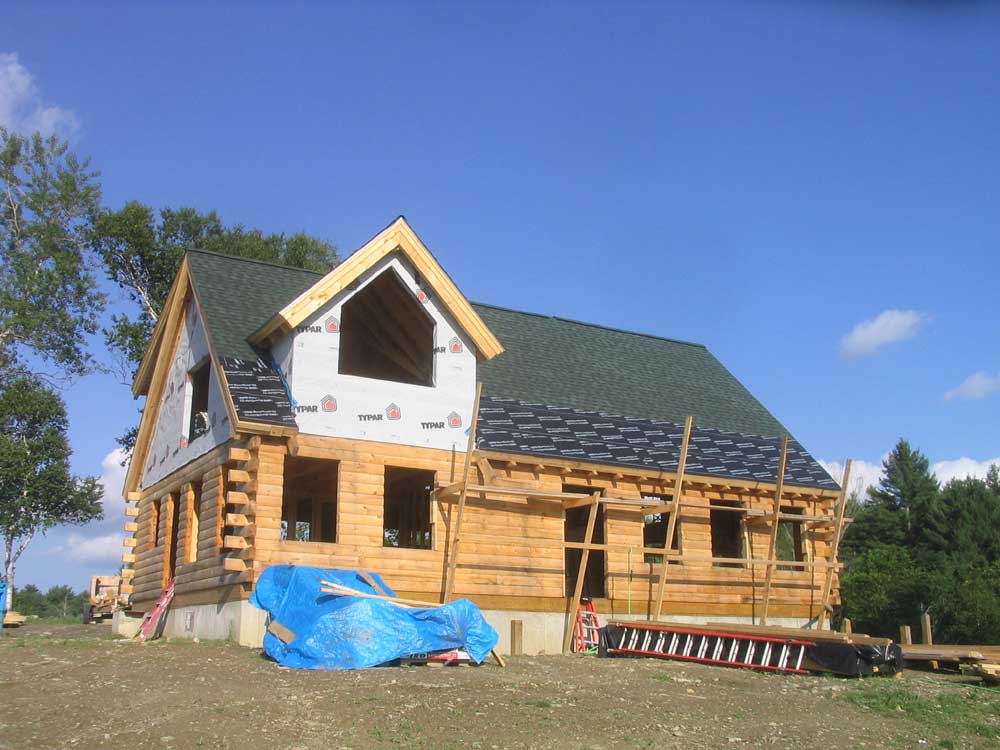

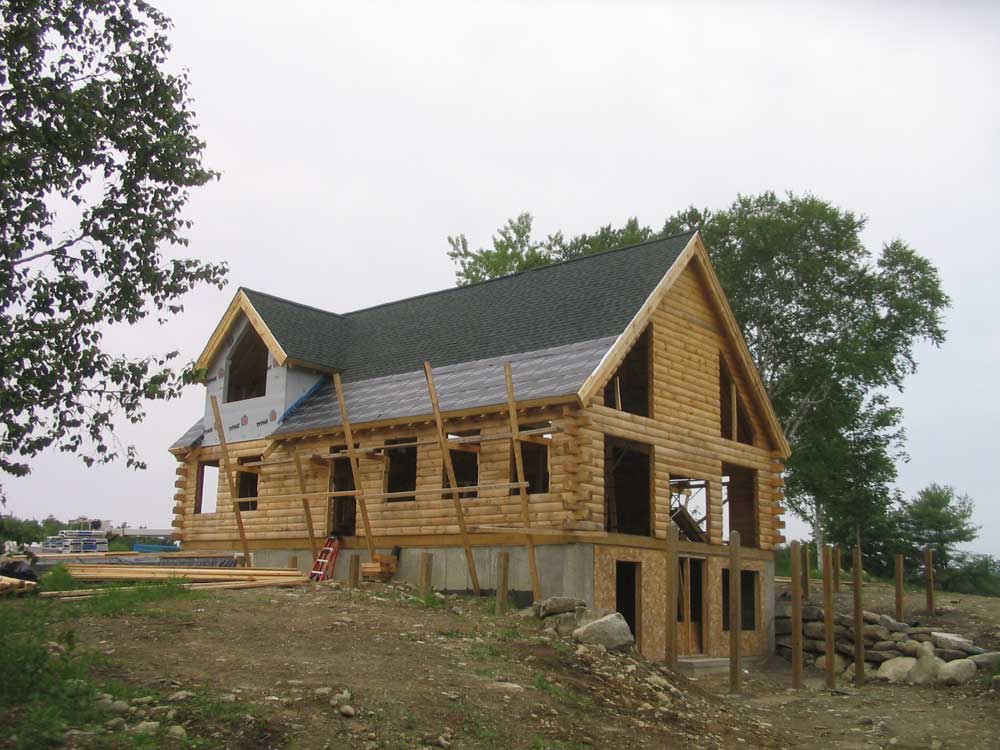

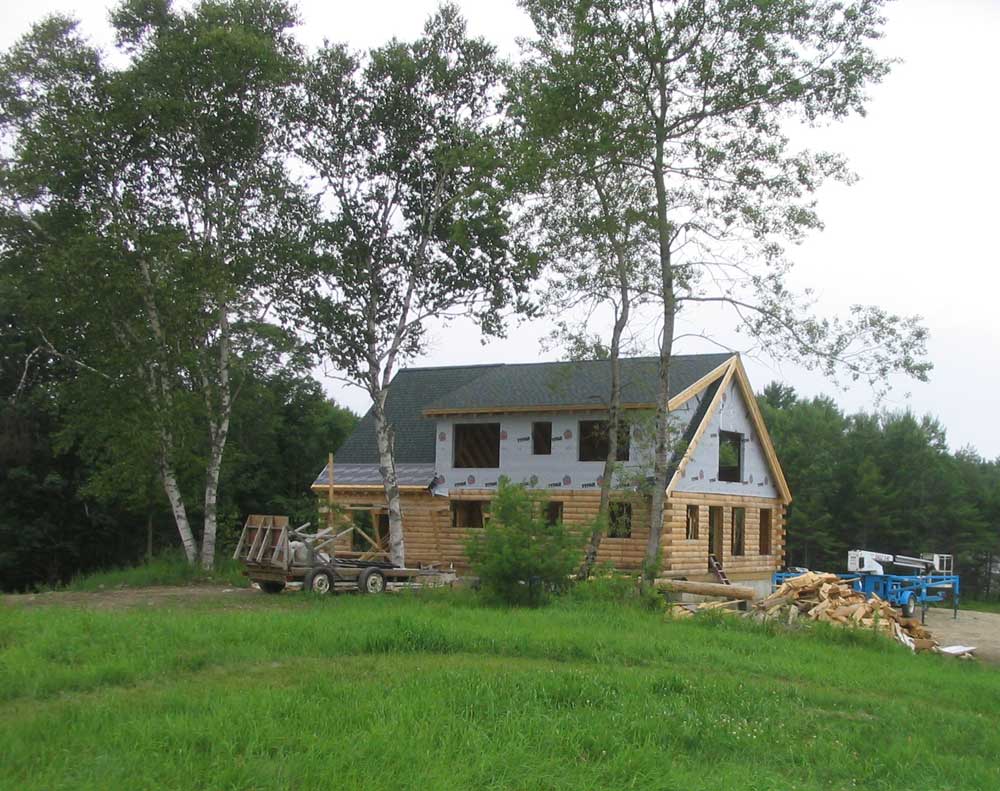

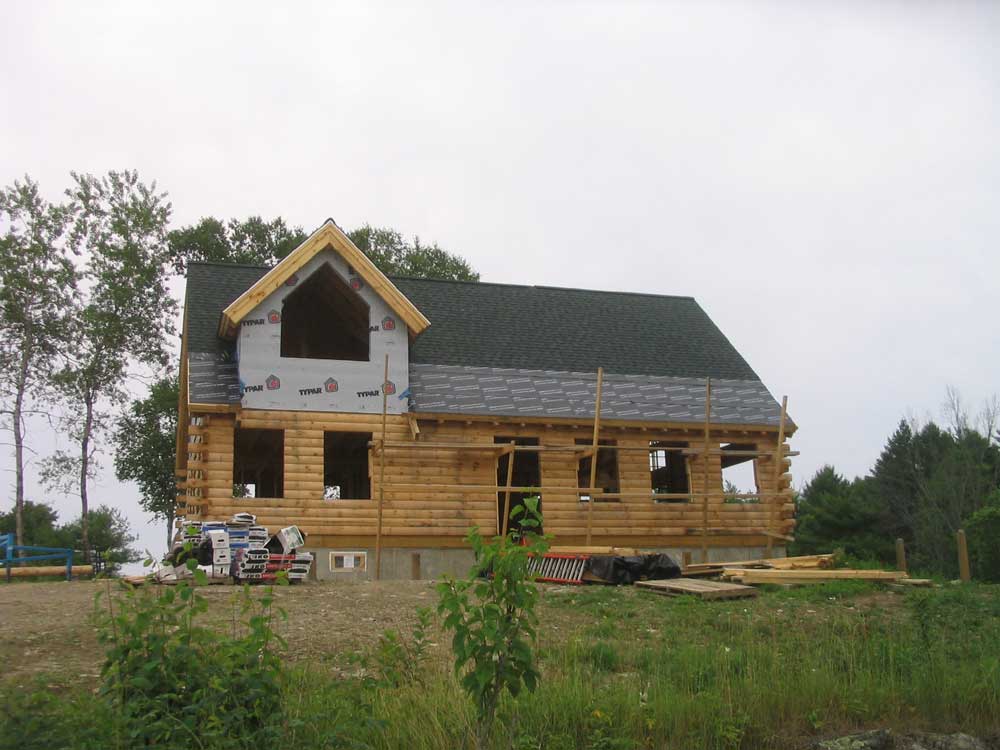

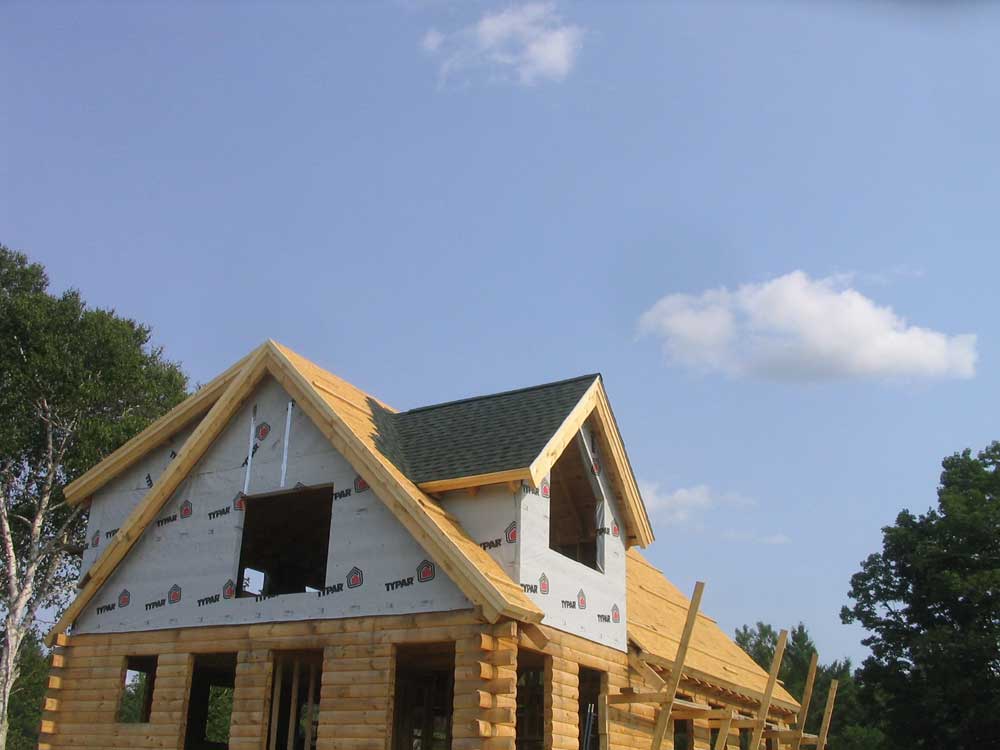

The roof is done!
Well, not really done, as you know from my previous posts, but done for now--and dry.

We got going this morning on the back roof and quickly finished up that area:  installing some Typar housewrap on the dormer cheekwall, removing staging, and installing the Roof Gard on the lower section.

With that done, we moved around--finally--to the front.  I won't bore you with any detail here:  Bob roofed and I lugged.  The usual.   I had found over the previous days that I was becoming more and more comfortable on the roof and staging, and that was a good thing.  On the steeper roofs, I had to carry the shingles up farther to keep Bob from continually coming down to grab shingles.

We finished up the roof with ridge vent, cap shingles, and the usual Roof Gard at the lower end where the porch roof would eventually go.  I thought the dark green shingles really brought the house "down" to the site and it suddenly appeared less of a construction project and more of a house with the roof done.  As usual, covering over the Advantech is always a great thing, wherever it may be installed.

The end of the roofing also signaled a significant change in the project:  Bob was all done, for now anyway.  Later, he'll come back and help me install the windows (or is that the other way around...), and will also return when it's time to build the porches.  But basically, I would be on my own from here.

The next projects would be quite a change--cleaning the interior logs and ceilings, sanding, and finishing as needed.   Plenty of work, but beneath a dry roof!

In case anyone's keeping track, today was work day 48--some days longer than others, some by myself, some barely worth noting--but in any event this was the 48th day work had occurred since May 1.

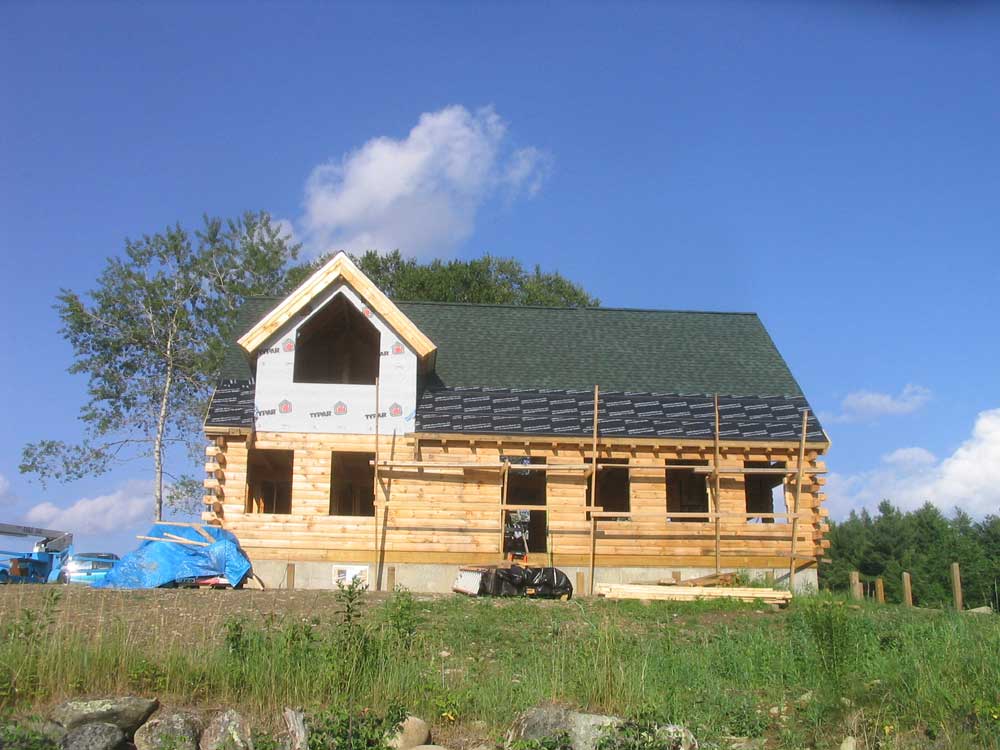

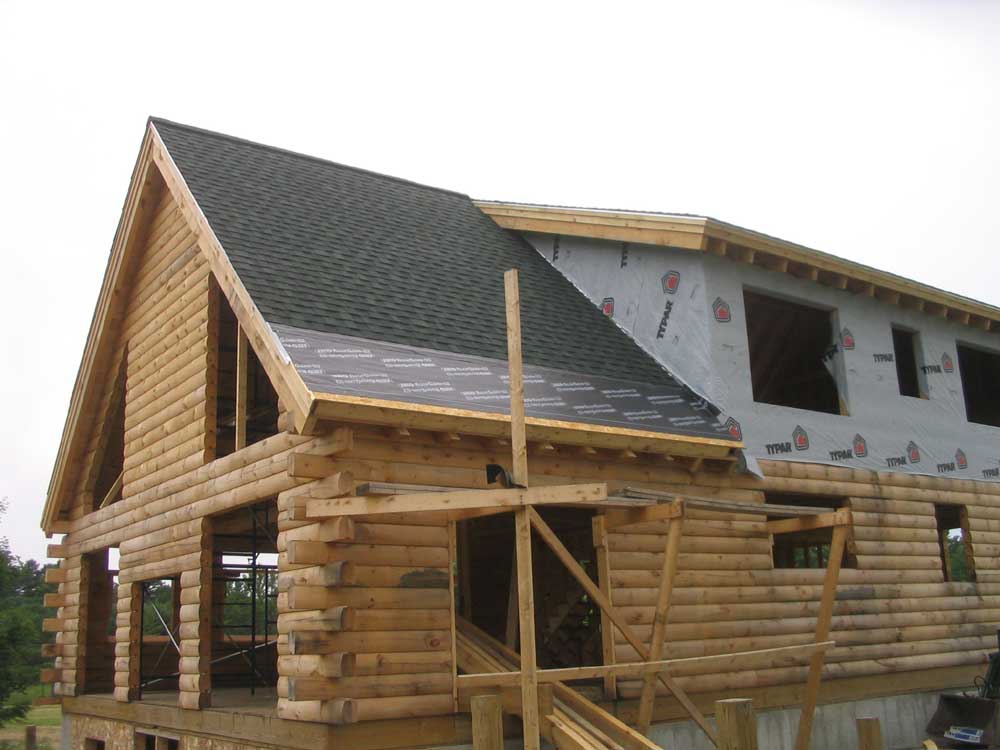

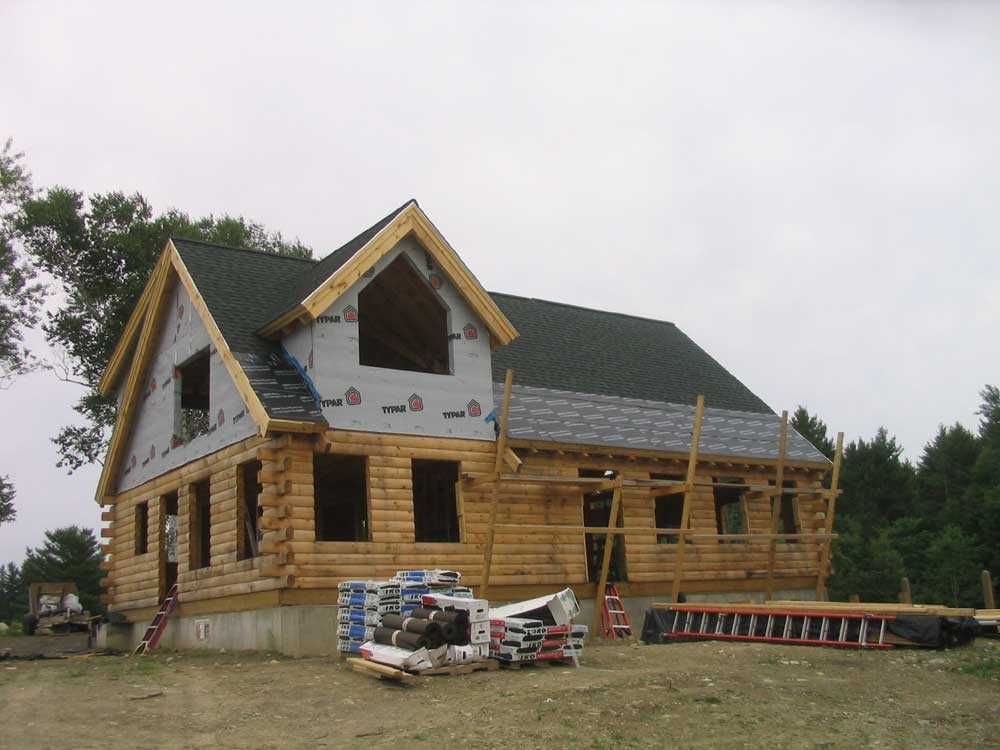

And now here are a couple gratuitous photos of the finished roof, just because I'm so excited about it.




TUESDAY, JULY 11, 2006

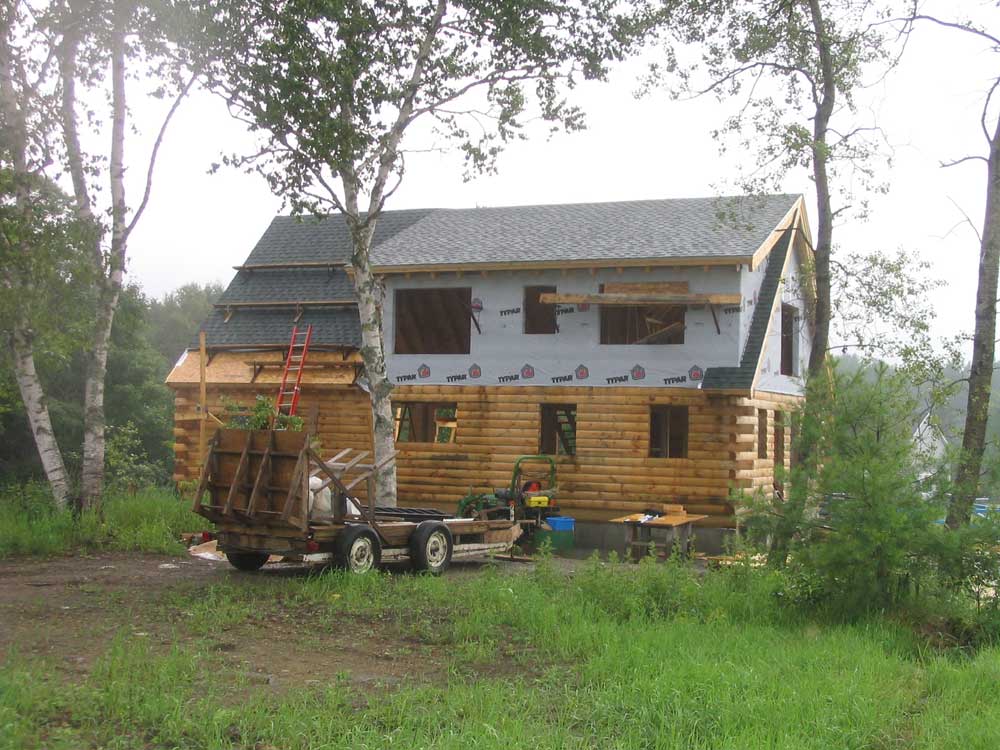

We got to work first thing this morning on the second section of the back roof.  As with the front of the house, we plan a covered porch--this one screened--off part of the back, so we began shingling far enough up to allow for later installation of the screen porch roof and shingles.  The process was much the same as before:  haul up shingles and other supplies for Bob.  Because the ladder climb was so much shorter, however, this was far easier today than yesterday, which was good since I was still tired.

The humidity was even higher today, and it was very warm.  As the sun shone more brightly through the morning, the shingles became very soft, and by the time we reached the peak of the roof section it was clear we would have to stop, since the risk of damage to the shingles was too great.  We even left the roof staging in place and left the step flashing along the dormer wall for later on, if it got cooler.

So this ended our major roofing effort for the day.  I was once again of mixed emotion:  glad to be done hauling shingles for the day, but sorry not to get more of it out of the way in a single day.

We continued work on the "false rafter" on the north gable, and finished up the substructure and trim as needed.  This work went more slowly than anticipated for several reasons, not the least of which was that it was a surprisingly complex little section.  But the slowness was compounded by the fact that at lunchtime, we began to be beset with just-worse-than-nuisance showers:  too heavy to work in, but too brief to quit for good.  So short bursts of work were interspersed with breaks waiting for the rain.  We managed to get the little roof section done, and covered with shingles and step flashing.


This roof incorporates the beginnings of a section of "fake" roof that will eventually run all the way across the back of the house, tying the two steep sections of roof together just above first floor height.  This small detail will add significantly to the looks of the house, as well as help protect the logs beneath with the overhang.  For now, we just worked on the very beginning of this small roof, so that we could finish up the gable side.  Later, we'll add false rafter tails, spacers, and trim to match the rest of the roof and tie everything together.  It will look very nice.

By late afternoon, it was clear we would soon have a more significant storm coming through, so we wrapped it up.  Hopefully, we can get some real work done on the shingles tomorrow and get that over with.  Then, perhaps, the still-barren front of the house might have some color!

The good news is that even with torrential rain from the afternoon's thunderstorm, the inside of the house stayed very dry, other than the rain that came in through the window and door openings.  Yahoo!


MONDAY, JULY 10, 2006


I can't say I was looking forward to a long day hauling shingles up a long ladder, but somehow it helped knowing that we'd get that much closer to a dry roof during the day.

We got started right away on the shed dormer roof in the back of the house, which was in partial shade from the birch trees.  It was also the highest part of the roof, with the longest ladder climb since it was the only two-story part of the exterior. It was a hot, sunny day with high humidity, and it didn't take long for the conditions to become rather tiring.


At first, I thought I might try carrying the shingles from their storage area in front of the house to the second floor by using the interior stairs.  Then I thought I could get bundles of shingles onto the staging out through the windows before climbing the ladder--unladen--and then lifting the shingles the short distance from the staging to the roof.

Quickly, though, I found that I didn't like this plan.  The staging was sort of scary, frankly, with warped planks rocking back and forth and barely tacked together with junky sheets of scrap OSB, and getting a grip on 90-pound bundles of shingles on two plank-wide staging 20 feet off the ground was just not a good plan for me.  So instead, I was back to carrying the bundles up the ladder.  It was easier than carrying the sheathing up last week because although the shingles weighed more, the weight was more concentrated and easier to balance.


I lost track of how many bundles it took to cover this section of roof, but it was plenty of them.  I tried to always keep at least two unopened bundles up on the roof ready for Bob, and in between I caught my breath, gophered other materials that Bob needed (nails, felt paper, etc.) and cleaned up paper and shingle bundle wrapping that the wind was blowing all over as Bob discarded them.

After we finished up the shed dormer roof, we moved around and got to work on the front roof next to the gable dormer.  Starting 8' up from the fascia to allow for later installation of the porch roofing, Bob shingled up beside the dormer and through the valley to the ridge, finishing in time for a late lunch.  This small area took quite some time because of the large number of cuts required.

Alongside the dormer, and in the section down to the fascia, we installed IKO Roof Gard as a weatherproofing measure to protect the roof until the porch could be built later.  We sealed the Roof Gard to the cheek wall of the dormer with rubberized Visqueen flashing material as a temporary measure.

After lunch, it was too hot to continue roofing; we might have damaged the soft asphalt with footprints or other marks, so we moved on to the trim on the south gable end.  The job was simple, but because it required use of the man lift it took some time to reposition the lift (twice) and get set up.  Installing the pine trim went smoothly, however, and this brought us to the end of the day.

Look for more roofing progress tomorrow!


FRIDAY, JULY 7, 2006

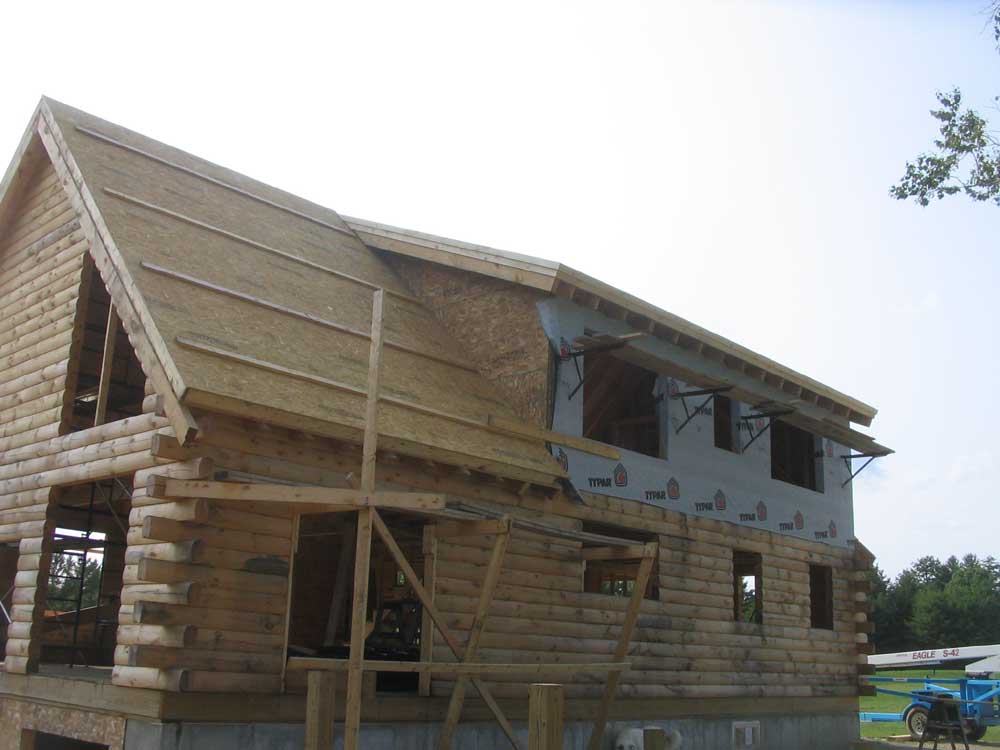

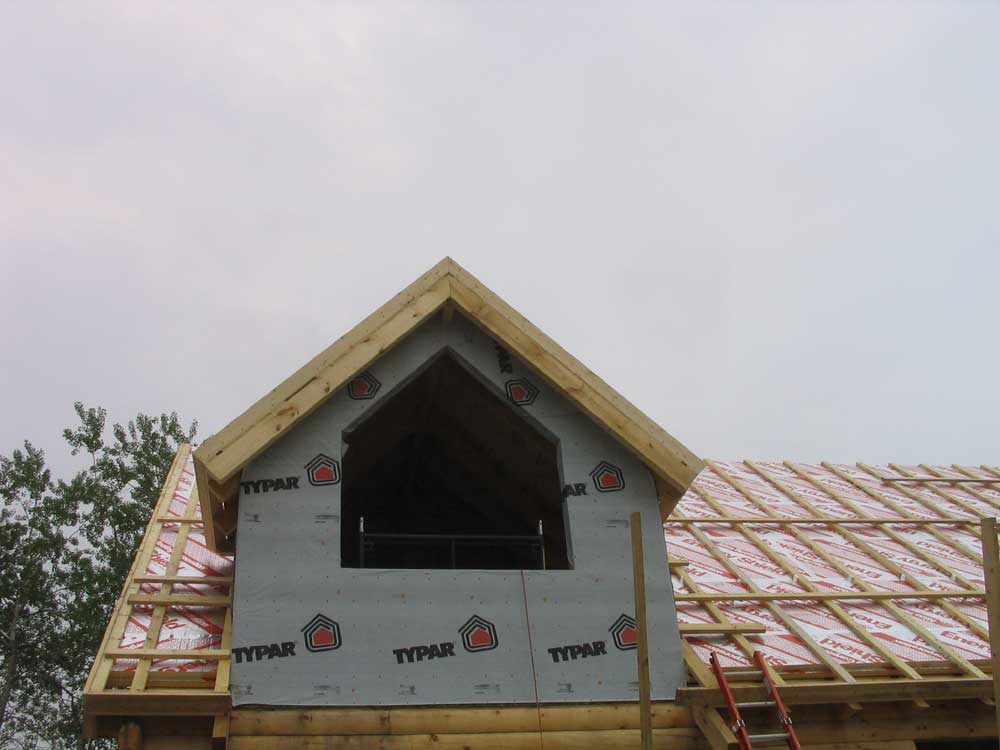

We got started this morning on the front dormer roofing.  The dormer had to be roofed first because of the plan for closed valleys (rather than open valleys which incorporate wide areas of exposed flashing).  The shingles from the dormer run through the valley and onto the main roof in a closed valley, and therefore must be installed first.

As with all things, the dormer roof took longer to shingle than its small size might indicate.  As usual, I was the material man (read: grunt) while Bob installed the shingles on the roof.  We began with appropriate amounts of Ice & Water Shield in the valleys and at the base of the roof, followed up with the traditional felt paper over the remaining sections.

I was pleased with how the roofing looked.  We chose a dark green architectural shingle to compliment the setting and the other materials in the house.  Somehow, it managed to take several hours to complete the roofing and ridge vent on the small dormer, illustrating once again how labor-intensive this feature is.  Fortunately, this particular dormer, while important from an aesthetic standpoint, is also an important feature for the space in the bedroom upstairs, so the effort remained worth the time involved.

We had originally planned to continue with more of the roofing, but after a break for an early lunch, we decided to change our plan a bit.  Since there will be a full-length covered front porch on the house--a porch that, not being a priority item right now, will be built a little later on in the process--we needed to allow for roofing the porch and incorporating that roofing into the main roof.  Originally, we thought we'd just roof the main roof now, and deal with blending the shingles from the porch roof into the main roof later, when we build the porch.

After some thought, though, Bob decided that it would be a better job if we could avoid shingling the bottom portion of the roof--that which would be covered by the porch roof later--and then tie in the porch shingles later, beginning at that point.  We discussed the pros and cons of the options, and I was soon convinced that it made better sense to do it this way.  This led to the question of how to waterproof the lower portion of the roof, however. I wasn't excited about using the felt paper, which doesn't hold up well if not covered, and the Ice & Water Shield has to be covered shortly after installation and cannot be left exposed, though it is completely waterproof.

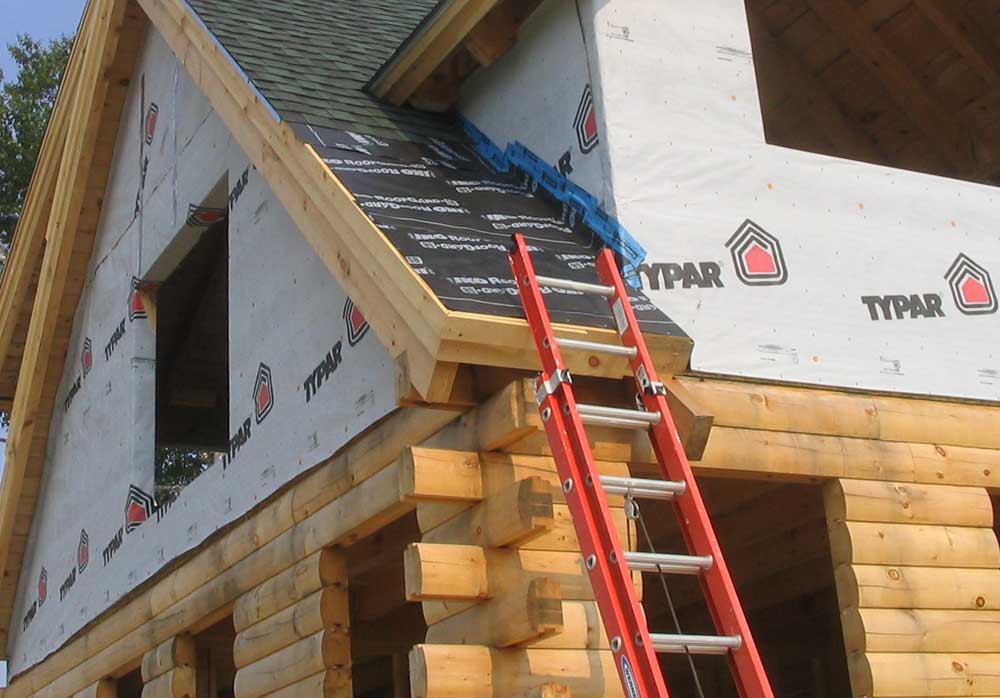

Therefore, we decided to cover the bottom of the roof with a product called Roof Gard--a tough, water- and weatherproof membrane that Bob had used on my shop last winter.  This stuff would hold up fine during the delay until we could build the porches--probably a couple months.  This, along with the shingles elsewhere, would guarantee a waterproof roof, so that I could get to work on the inside.  Since we didn't have this material on hand, it pretty much put an end to the roofing for the day.  Instead, we decided to work on the trim around other portions of the roof.

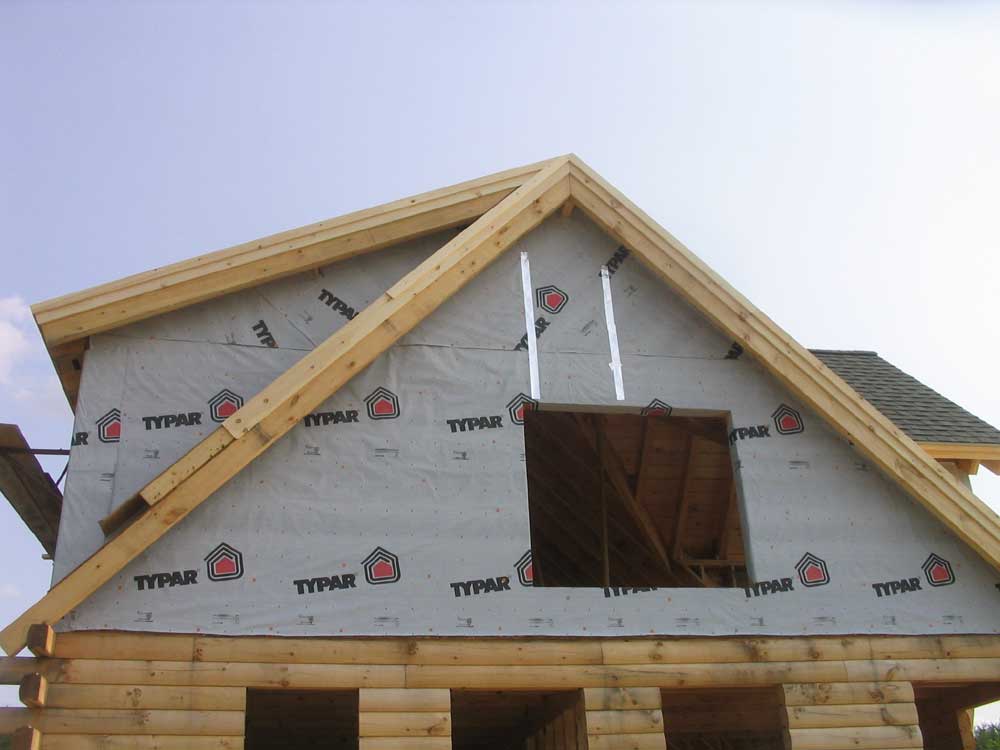

During the afternoon, we completed all the roof trim except for the south gable end, which we'd do just a little later after we had worked the roofing down towards that end.  As before, we installed the two sections of trim, with Bob installing and me cutting.  The trim went smoothly and took the rest of the afternoon.

With luck, we hoped to get a large portion of the roof covered on Monday.

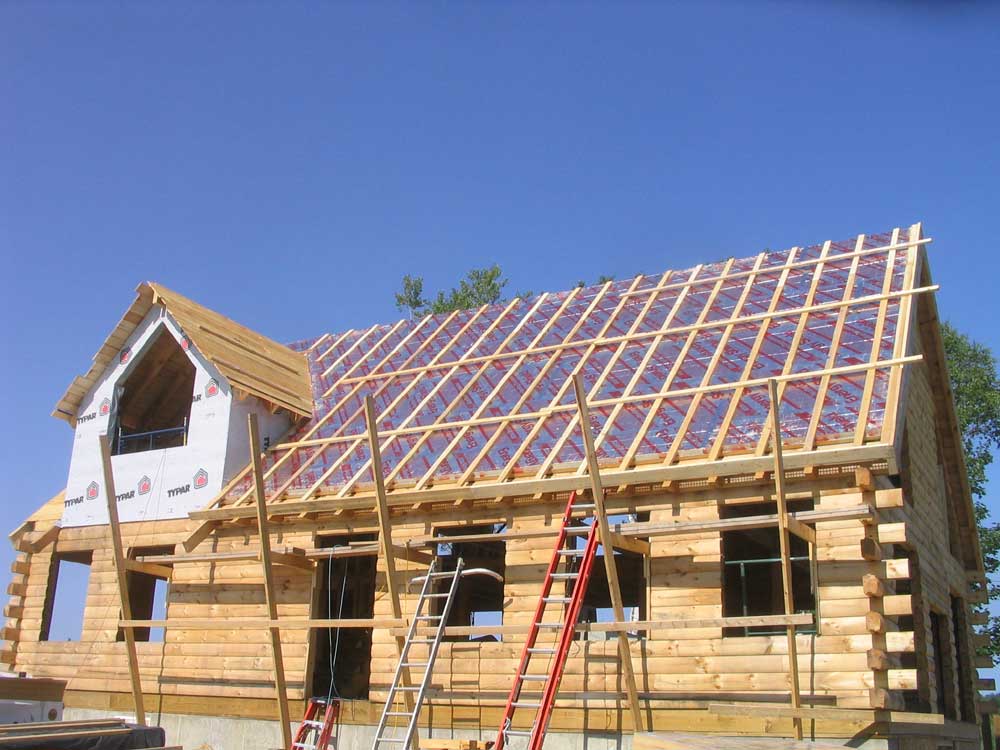

THURSDAY, JULY 6, 2006

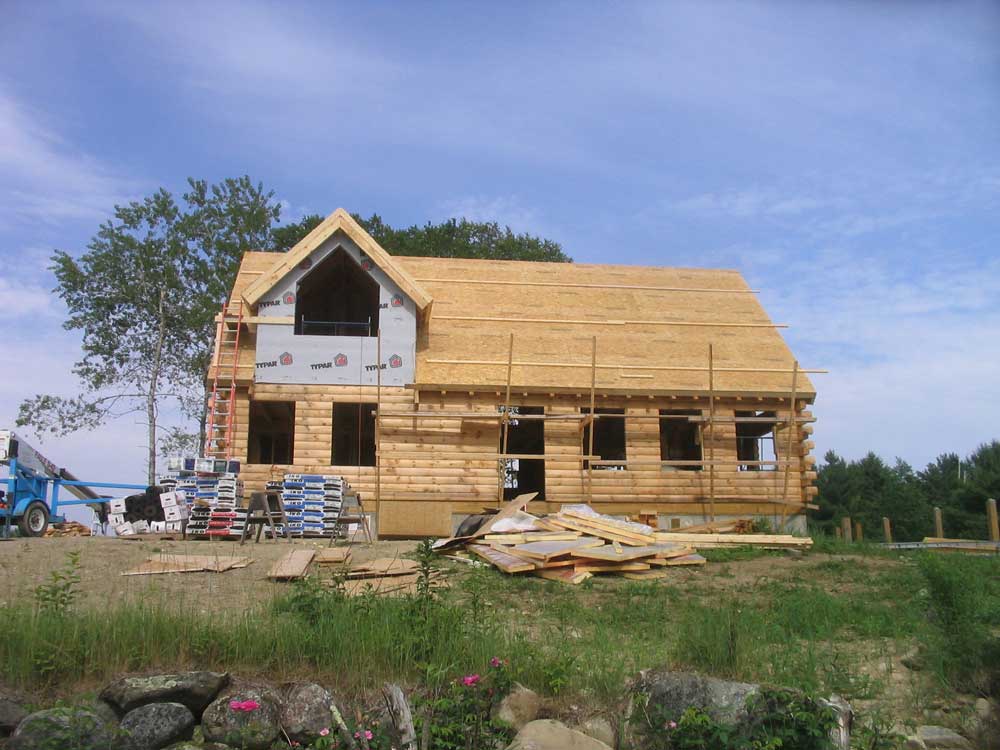

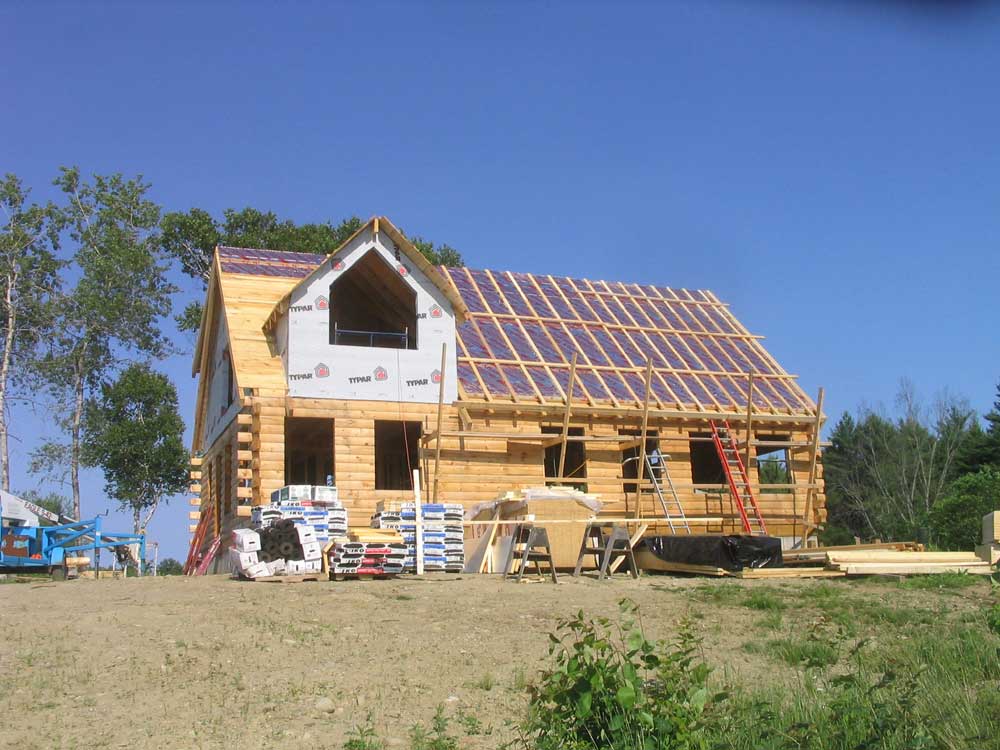

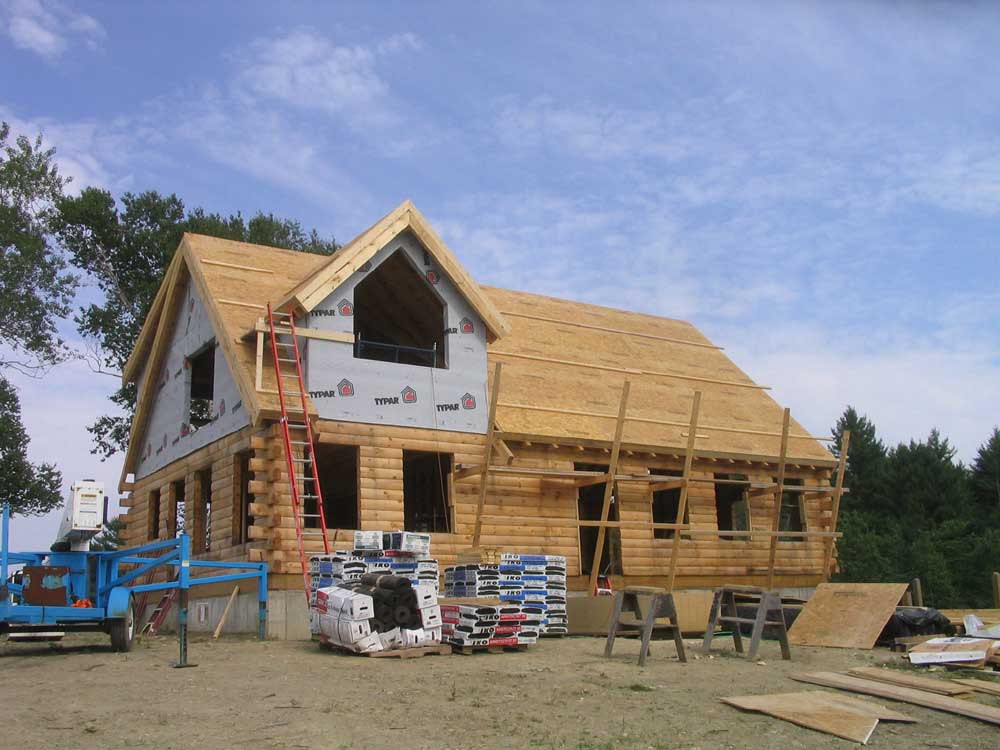

Yesterday, I wrote:   "I don't know whether we'll finish the roof sheathing in a day or not.  Based on past performance, I'd say no...".

Apparently, I vastly underestimated the potential of two such handsome, strapping, and hard-working individuals.  (Who were those guys, anyway???)  We finished up the last remaining side of the front dormer in short order, and moved around back.  Sheathing the shed dormer was initially daunting thanks to the extra-long climb up the ladder, laden with full sheets of Advantech.  To carry up the sheets, I lifted each approximately in the bottom center of the long side (8'), then balanced the sheet against my shoulder and head to support it with the one hand while using the other hand to climb the ladder.  Excellent stuff, this.


I had the wrong grip on the sheet the first time--the technique that had worked for me on the front side was failing badly now--and nearly lost control several times on the way up--hardly an auspicious start.  I managed to regroup and came up with a better system, and we completed the shed dormer sheathing without further incident, though it was exhausting.




We finished that up at 10:30, and I had to run down the road several miles to the nearest lumber store to pick up more gun nails, as we were nearly out.  The respite in my air conditioned truck was much needed, and when I returned we finished up the back side of the main roof--a relatively small section that went quickly.  By about 12:30, we were all done with the sheathing, and I was most pleased to put it behind.

Next, we moved on to something much more interesting and fun:  the roof trim.  The trim has to be installed before roofing can begin.  I brought my shop-based sliding compound miter saw up after lunch, and informally retired the big Hitachi 15" chop saw that had seen us nicely through the logs and floor/roof beams.  It wasn't a trim saw, and it was time to switch tools.

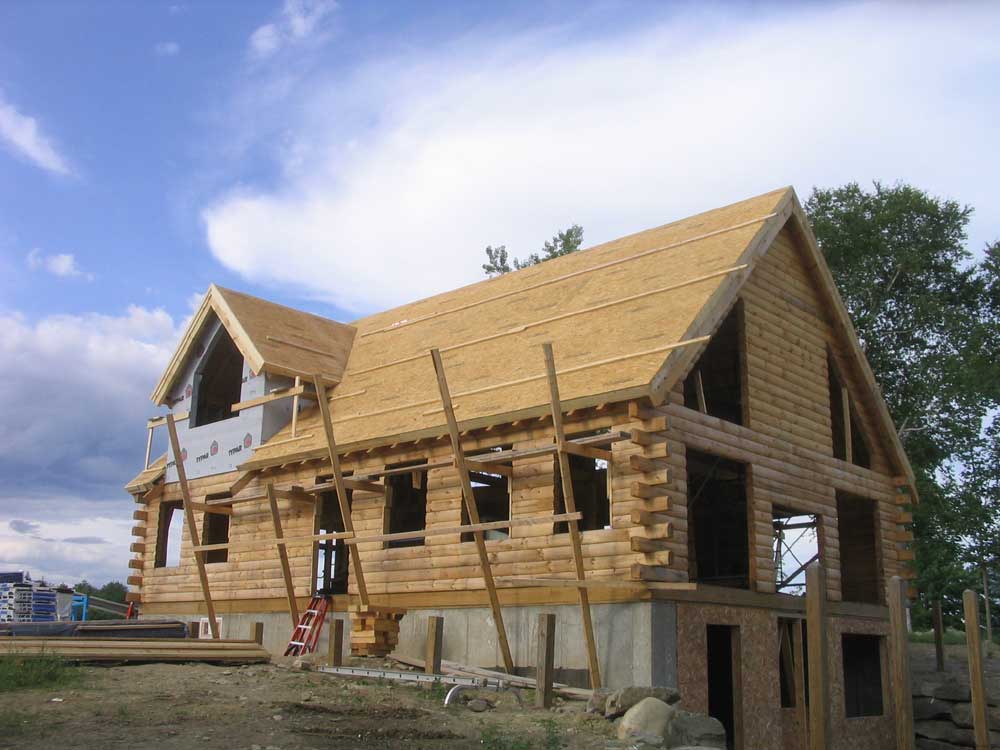

Since the front dormer needed to be roofed before the main roof (because of the way the valleys work), we began with the trim on the dormer.  The trim is pretty straightforward:  an 8" (really 7-1/4") pine board, held flush with the roof sheathing at the top and hanging down just a small amount onto the pine rafters or rafter tails (depending on whether it's a gable or sidewall, respectively), followed by a 4" (really 3-1/4") pine board at the top, creating a second shadow line.  Standard stuff.  Bob used his manlift to measure and install the trim while I cut the boards to the necessary lengths and angles down inside the building.

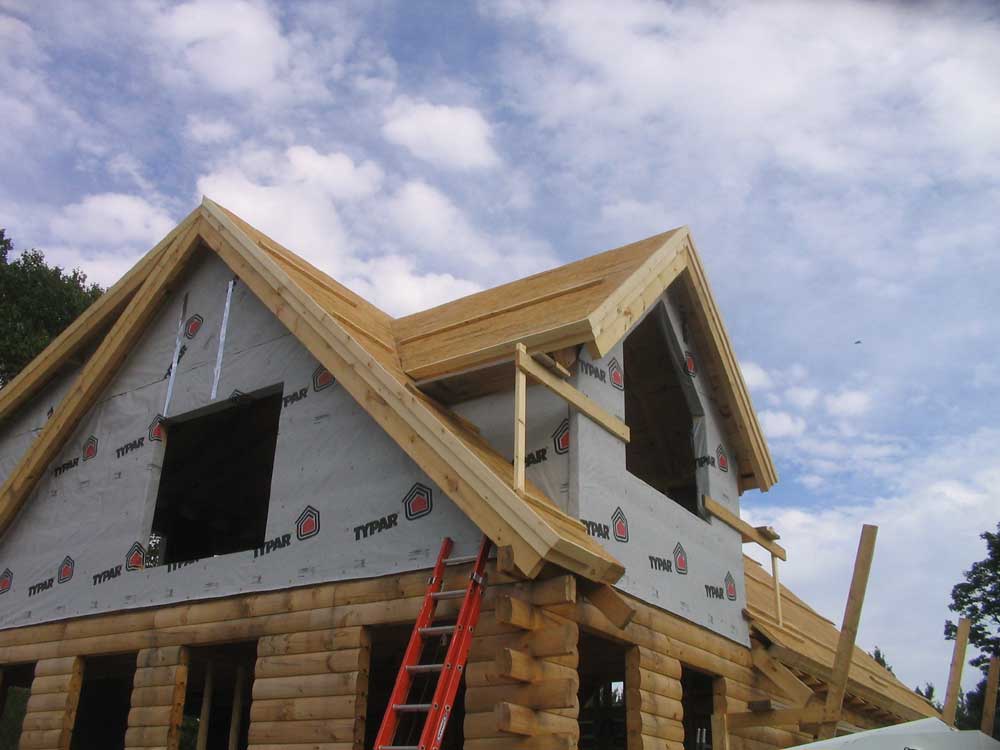

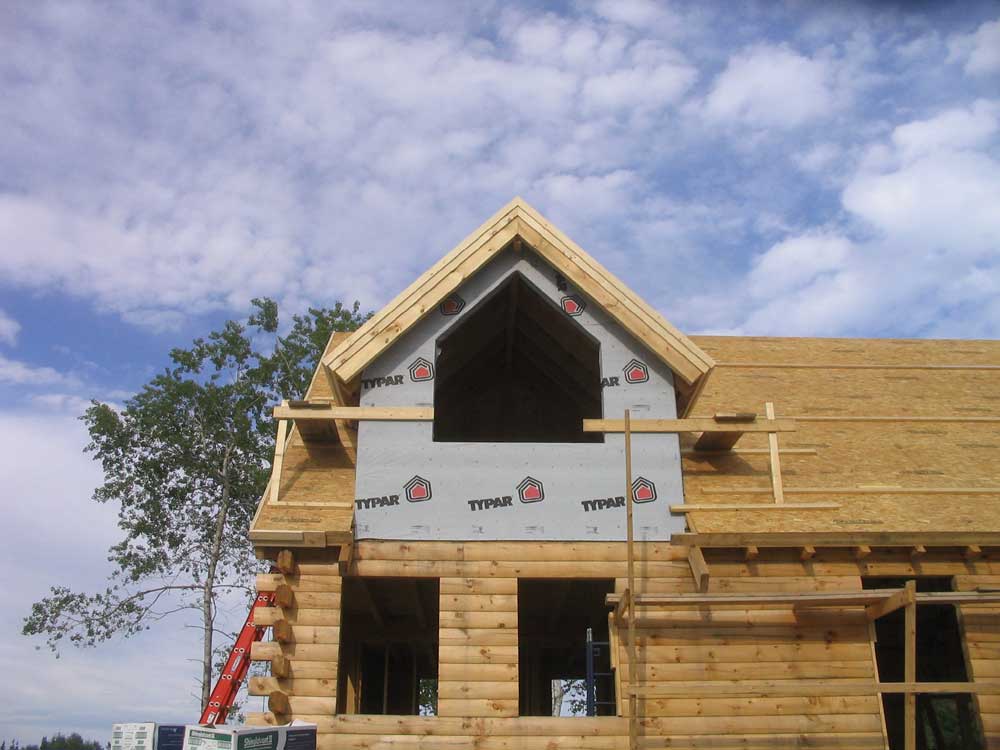

With the dormer trim complete, we installed the trim on the forward side of the north gable end--the side at which we intended to begin shingling.  We ran a short section of the trim around the front corner of the house; since this area would later be completely hidden by the front porch roof and trim, these boards were temporary and for alignment purposes only.

This brought us to the end of the day.  It was a good day (particularly once 12:30--and the end of the sheathing--rolled around.

Perhaps tomorrow, if you're really, really good, you'll see a surprise.


WEDNESDAY, JULY 5, 2006


Today, we finished up the one dormer side that we had left uninsulated, and then moved--reluctantly but necessarily--to the roof sheathing.

There's not much to tell about the process.  I cut sheets and lugged them up the ladder to the roof and Bob, who installed them and nailed them in place.  It was unpleasant work, but the sheets covered quickly despite it all.  We covered most of the front of the house, except for (as usual) half of the infernal dormer.  I would have pressed on and finished the one side, but Bob was understandably worn out from the work on the 45° angle of the roof.  I wasn't unhappy to quit, as I was worn out too, but I would have rather completed the front for another hours' work and thereby reduce the misery the next day.


I mentioned earlier how I was not a roof guy.  Frankly, I'd rather grind black bottom paint off a dozen Carver powerboats than sheathe one more roof.  That doesn't mean I want to grind the paint, but perhaps it puts the sheathing job into perspective.

Tomorrow:  more of the same.  I don't know whether we'll finish the roof sheathing in a day or not.  Based on past performance, I'd say no, but stranger things have happened!


TUESDAY, JULY 4, 2006


Happy birthday, USA!

This country wasn't built by sitting around, and neither will this house be.  So Bob and I decided to work today.  Clearly, our informal goal was to finish up the insulating steps on the roof.

We began with some final trim bits on the gable of the front dormer, including the two 4x8 pine rafters, which we installed with the help of the man lift as on the other gable ends.  This process went smoothly, and once the final fly rafters were installed, we moved onto the now-standard 2x6 boards above, as before.


Then we continued with the insulation.  The dormer lived up to its burgeoning reputation as the most time-consuming aspect of the build, and the tedious process of cutting and fitting the insulation and related installations took a long time.  By noon, we had completed the remains of the main roof (the small section to the left of the dormer), and the left side of the dormer.  I had hoped to finish the insulation today, but Bob had other plans for the afternoon (fair enough), so we called it a day.  It was just as well, as I was getting a little tired of the insulation, the dust from cutting, and fighting the light sheets against the wind.  Insulation is just never fun.

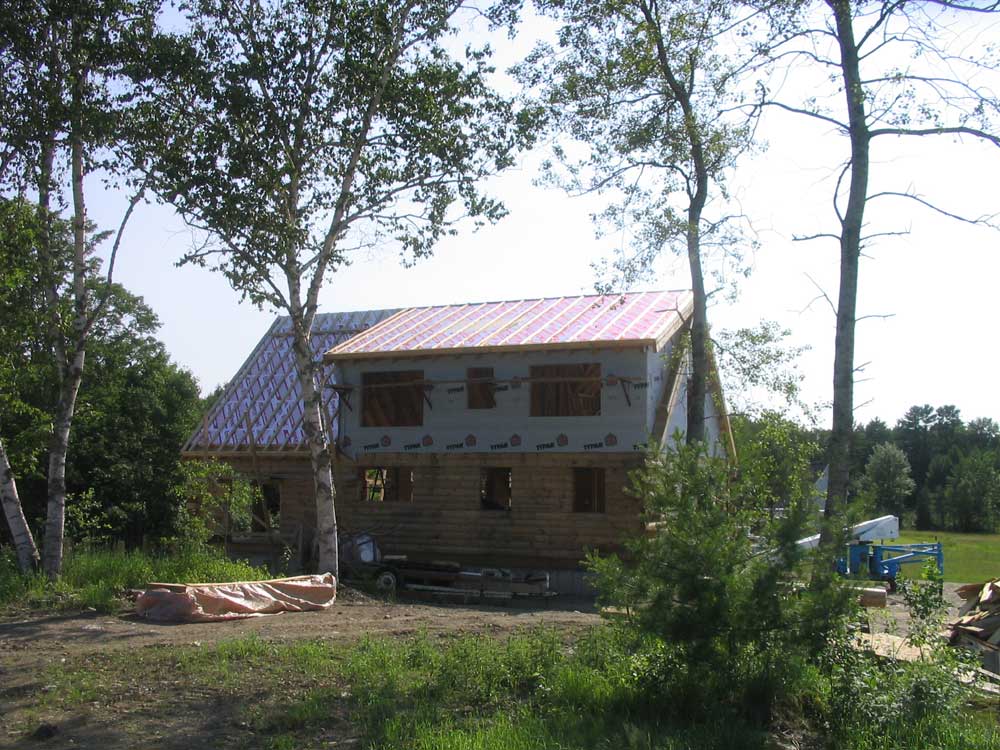

MONDAY, JULY 3, 2006

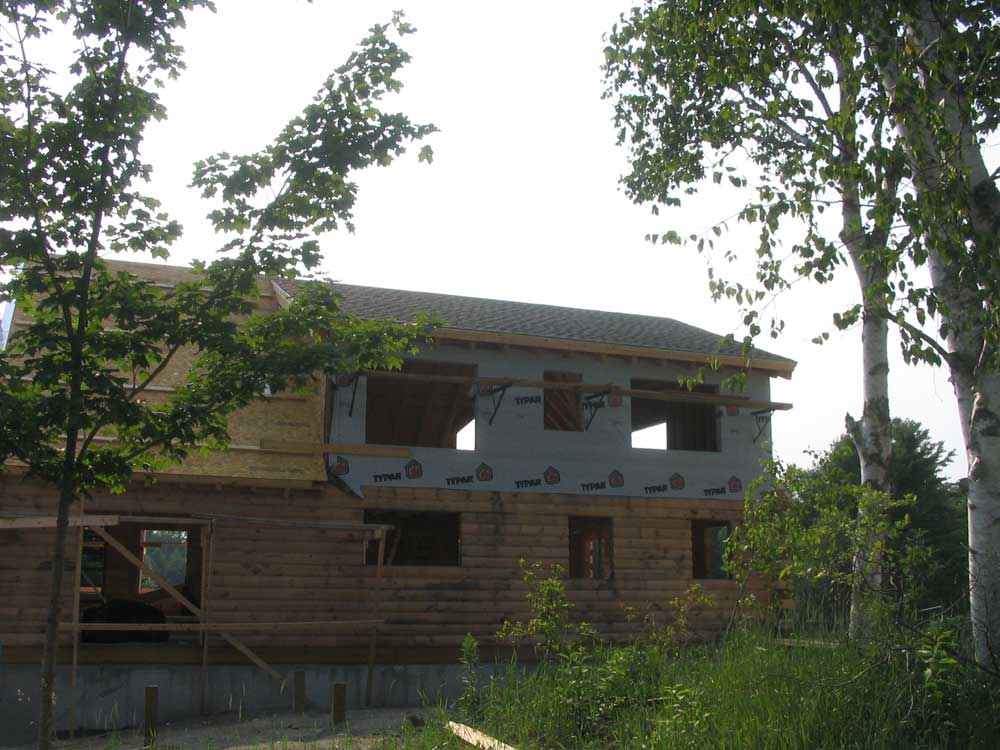

We got right back into it this morning by finishing up the incomplete strapping on the back shed dormer, which we had rushed through on Friday with imminent thunderstorms nearby.  After I passed up the 2x4s required, I filled some time moving the sawhorses, tools, and other things around to the front of the house while Bob screwed down the strapping.  Our progress was temporarily slowed when my electric impact driver, which we had used consistently throughout the build to install the screws, burned up, spitting out bits of carbon-like insulation from inside the motor, having been pushed too hard.  (Fortunately, the manufacturer will rebuild these for little or no charge under the warranty.)  We finished up the day using Bob's identical tool.

We continued the insulation process on the front of the house.  There was little advance work required.  The roof boards on one side needed to be trimmed off, but with that complete we were ready to go.  We installed the requisite 2x6 at the gable edge of the roof, and then began installing the sheets--I passed them up from the ground, and Bob spiked them temporarily in place.

Throughout the day, we continued in this manner.  It was a bright, sunny day, and the foil-faced insulation reflected significantly, whether on the ground or on the roof, making it rather warm to work with; much like being on the water, the effects of the sun were enhanced greatly by the reflectivity factor, and we consumed much water throughout the day.  We covered the bulk of the front roof, taped the seams, and installed the 2x4 strapping, ending around 3:30.  All that remained was the front dormer and a very small section of roof outboard of that on the north side.  It would have been nice to finish up today, but I certainly wasn't about to ask for more than 8 hours of work on a shiny, steep, hot roof.
